In an earned value-based system, a schedule performance index of less than one for the project indicates the project is:
If a cost estimate assumes that 240 hours will be expended on a given activity, and the projected crew size expected to perform that activity is 5 personnel working and 8-hour workday, what is the calculated duration for the activity?
Select the most appropriate explanation for use of a winter/wet weather seasonal calendar for use in this project?
The expected remaining cost needed to complete an activity, group of activities or the project is the____________.
An earned value-based project control system can use either of which two budgets as the basis of its calculations?

Which of the following options is NOT a feasible method to reduce the overall completion time of the toll road program?
A driving relationship is _____________________.
The EBS is established by:

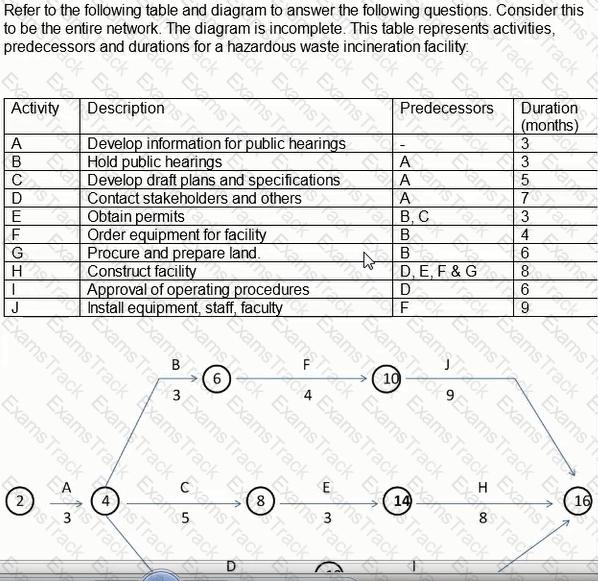

Identify the late finish to develop plans and specs.

Determine the correct formula and date for the late start for Activity 9001.

|
