If someone wanted to constrain a project's end date so that any project slippage would cause negative float, they would do so by using
If after calculating a schedule an activity exhibits negative total float, which of the following is certain? The activity
Which statement is true?

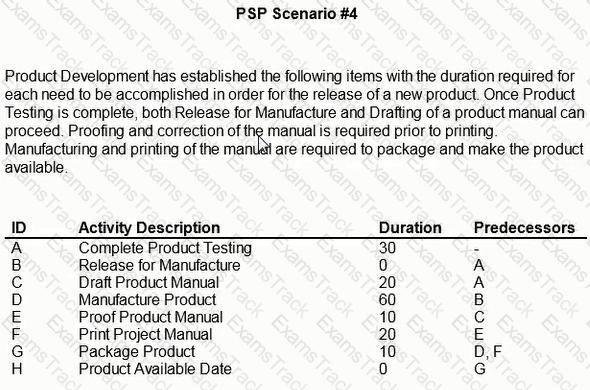

If drafting of the product manual overruns its planned duration by 5 days, how many days may the manufacturing be delayed without affecting release of the product?

The project team must communicate the project plan, goals and objectives to all stakeholders to ensure the stakeholders understand the plan, goals and objectives and then continue this communication throughout the project life Which statement below would stakeholders NOT be expected to contribute?
When are project planning and scheduling specifications established?
If Activity A was delayed 5 days from starting, which of the following adjustments will NOT maintain the completion date of Activity C at Day 40?
Which of the following procedures is generally recognized as acceptable when updating a schedule?
Determine the correct formula and date for the late finish for Activity 2002.
|
