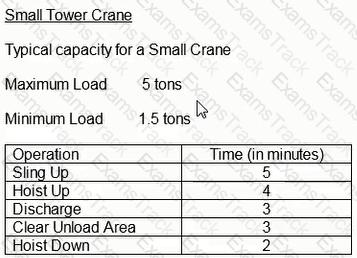

There is only enough room for a maximum of 4 cranes to be placed on-site. Assuming that a single crane can perform 35 lifts per day and that a column pour requires 60 lifts, what is the minimum number of tower cranes that should be used for the above described column pours?
Select the most appropriate explanation for use of a winter/wet weather seasonal calendar for use in this project?
For the late finish for Activity 11001, select the most appropriate response for transitioning from the forward pass.
Determine the driving activity for Activity 10001.
Using the "normal" schedule, theoretically construct a hammock for activities 6001-6003. What is the duration of the hammock?
In a graphical earned value analysis, what time-scaled value determines the reporting intervals for both schedule and cost performance?
Which of the following risks CANNOT be estimated by BILCO with only a resource-loaded schedule?
The characteristic of the precedence diagramming method that models construction projects differently than the arrow diagramming method is that it____________.
