Which of the following risks CANNOT be estimated by BILCO with only a resource-loaded schedule?
What is the result of a forward pass calculation?
Scenario: You are providing construction management services for a small office building project. Your duties include reviewing and approving the contractor's baseline schedule. The contractor has submitted the first baseline schedule for the project.
The contractor subsequently submits a CPM schedule for its baseline schedule submittal. As part of your review, you look at the durations for each activity in the schedule. How do you determine if a duration of 10 work days for drywall installation is accurate?
When resource leveling craft labor for a critical path schedule, the scheduler
The amount of time that an activity can be delayed from its early start date without delaying project completion is called:

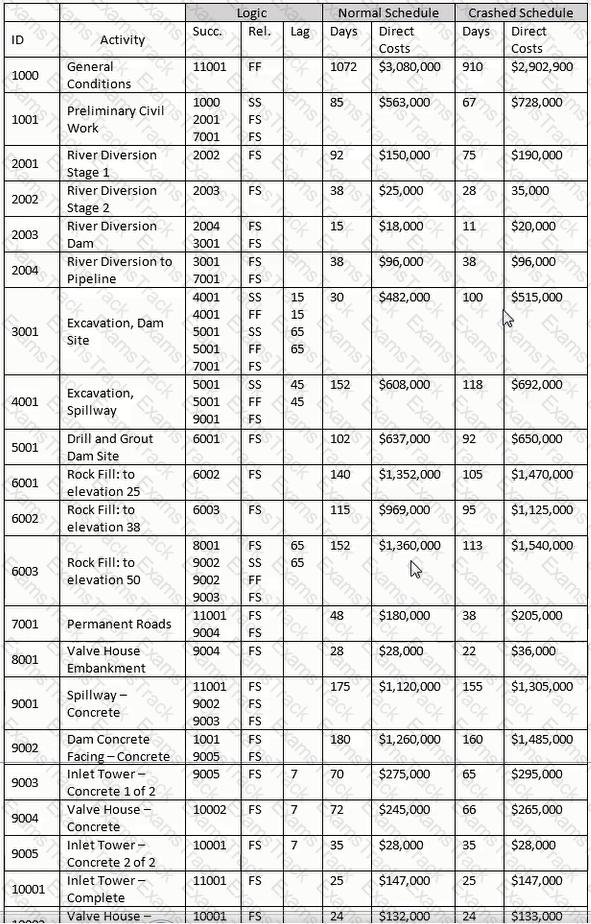

For the late finish for Activity 11001, select the most appropriate response for transitioning from the forward pass.

What day would Activity C complete if the duration of Activity B was reduced to zero?
You are retained by a contractor who asks you to perform a simple as-planned versus as-built analysis (APAB) of a large hydro-electric dam project that took more than five years to complete. Your analysis will form the basis of a change order that requests a time extension. You suggest using a different methodology for quantifying the delay. Which of the following reasons for recommending a different analysis does NOT apply to a simple APAB analysis?

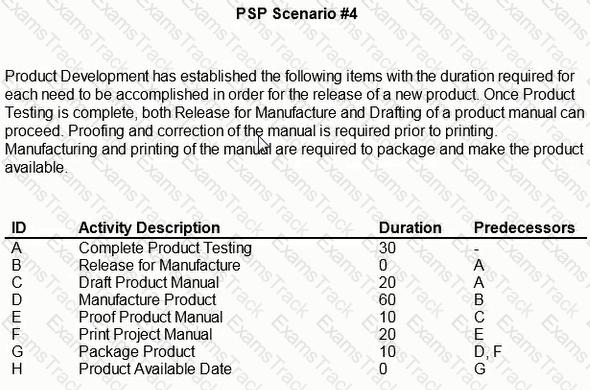

How much Total Float does drafting the product manual have?

|
