The project is now in the second week of Timebox C. This is the final Timebox of Project Increment 1 and is scheduled to take one month. The plan is to open
Hoy Hall to the public at the end of this Increment. A Must Have requirement of Timebox C is the implementation of a hotel reservation system.
At the Daily Stand-up, the Software Developer working on the reservation system reported that the framework for the system is now complete and ready for content.
However, this work cannot progress further due to a disagreement over the content. The Marketing Director insists the system is to hold professional photos and video
tours of the facilities and grounds. These require a lot of storage space and regular updates. The IT Operations Manager insists the system is to take less than 5GB of
storage space on the company server and require minimal maintenance.
The Team Leader has arranged a Facilitated Workshop to discuss the content and agree the way forward.
Remember to limit your answers to the number of selections requested in each question.
Which 2 individuals should the Facilitator invite to participate in the Workshop?
Who is responsible for approving that the change in priority of the requirement for a secondary exit from the upstairs of the building accurately reflects the scope of the
project in the Prioritised Requirements List?
Using the Project Scenario, answer the following question about the activities in the Agile project lifecycle.

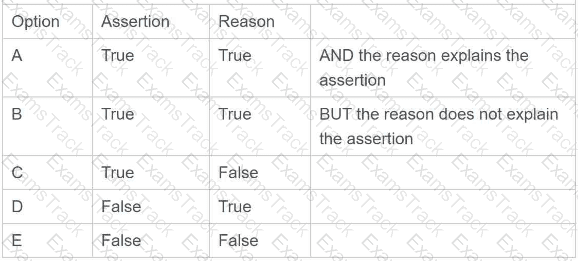

Lines 1 to 5 in the table below consist of an assertion statement and a reason statement. For each line identify the appropriate option, from options A to E, that applies. Each option can be used once, more than once or not at all.

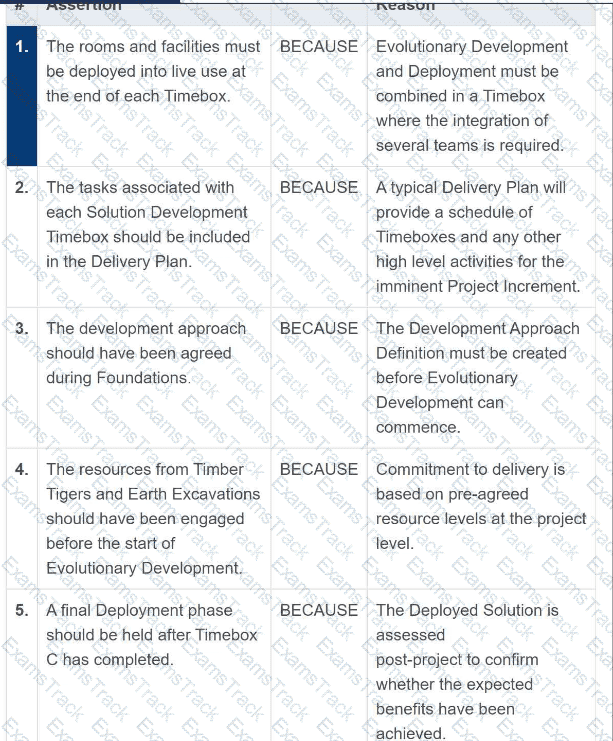

Assertion:-
1. The rooms and facilities must be deployed into live use at the end of each Timebox.
BECAUSE
Reason:
Evolutionary Development and Deployment must be combined in a Timebox where the integration of several teams is required.
2. The tasks associated with each Solution Development Timebox should be included
in the Delivery Plan.
BECAUSE
Reason:
A typical Delivery Plan will provide a schedule of Timeboxes and any other high level activities for the imminent Project Increment.
3. The development approach should have been agreed during Foundations.
BECAUSE
Reason:
The Development Approach Definition must be created before Evolutionary
Development can commence.
4. The resources from Timber Tigers and Earth Excavations should have been engaged
before the start of Evolutionary Development.
BECAUSE
Reason:
Commitment to delivery is based on pre-agreed resource levels at the project level.
5. A final Deployment phase should be held after Timebox C has completed.
BECAUSE
Reason:
The Deployed Solution is assessed post-project to confirm whether the expected benefits have been
achieved.


Answer the following questions about the acceptance criteria within the project.
Decide whether the approach to setting and using acceptance criteria has been applied appropriately and select the response that supports your decision.
When specifying high-level prioritised requirements during Foundations, the Business Visionary has suggested that acceptance criteria for the requirement to " temporarily weatherproof the roof " should NOT be set until Solution Development Timebox A.
Is this an appropriate approach to setting high-level acceptance criteria?
Which 2 actions should the Workshop Facilitator take when preparing for the workshop?
(Which 2 statements describe appropriate team behaviour for effective risk management?)
What action should the Project Manager take regarding the remaining windows?
What action should the Project Manager take to plan the deployment activities?
Which 2 statements describe the appropriate application of Agile Project Management when developing the Prioritised Requirements List during Feasibility?
(Hira discovers that material costs are exceeding initial supplier estimates, leading to a 5–10% budget overspend.)
|
PDF + Testing Engine
|
|---|
|
$49.5 |
|
Testing Engine
|
|---|
|
$37.5 |
|
PDF (Q&A)
|
|---|
|
$31.5 |
APMG-International Free Exams |
|---|
|
